Project

General

Profile

Gantt

Filters

Zoom in Zoom out « March | May »

months from Apply Clear

Feature #1330: My fist feature
Support #1332: Design support
Feature #1333: My First Feature
Feature #1334: Add “G11 Members” section to Wiki
Feature #1335: Feature 1
Feature #1336: Feature 2
Feature #1337: My Second Feature
Feature #1339: My first issue
Feature #1340: My second issue
Feature #1341: My First Feature
Feature #1342: My Second Feature
Feature #1344: Create member profile page for Phillip Anderson
Feature #1346: First feature
Feature #1347: Second feature
Feature #1348: First Feature
Feature #1349: Second Feature
Feature #1350: First Feature
Feature #1351: Second Feature
Feature #1356: Feature1
Feature #1357: Feature2
Feature #1366: FirstFeature
Feature #1367: SecondFeature
Feature #1368: Feature1
Feature #1369: Feature2
Support #1380: Finish UML Diagrams

Status

In Progress
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New

Priority

High
Low
Normal
Normal
Normal
Normal
Normal
Low
Low
Normal
Normal
Normal
Normal
Immediate
Normal
Normal
Normal
Normal
Normal
Low
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Updated

10/16/2025 02:12 PM
10/16/2025 02:11 PM
10/16/2025 02:22 PM
10/16/2025 03:17 PM
10/16/2025 02:33 PM
10/16/2025 02:35 PM
10/16/2025 02:36 PM
10/16/2025 03:07 PM
10/16/2025 03:07 PM
10/16/2025 03:53 PM
10/16/2025 03:54 PM
10/17/2025 12:30 AM
10/16/2025 03:42 PM
10/16/2025 03:43 PM
10/16/2025 04:04 PM
10/16/2025 04:04 PM
10/16/2025 04:14 PM
10/16/2025 04:14 PM
10/17/2025 01:10 AM
10/17/2025 01:11 AM
10/21/2025 01:21 PM
10/21/2025 01:21 PM
10/22/2025 01:35 PM
10/22/2025 01:36 PM
10/22/2025 02:12 PM
10/22/2025 02:14 PM
10/23/2025 02:38 PM


15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39

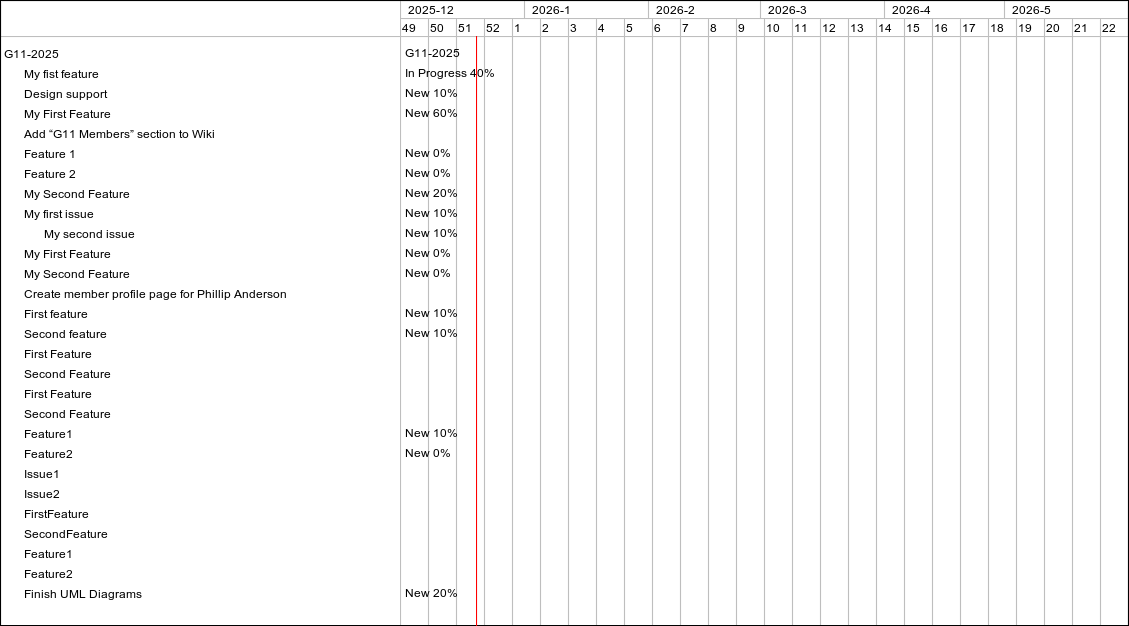

G11-2025
In Progress 40%
New 10%
New 60%
New 0%
New 0%
New 20%
New 10%
New 10%
New 0%
New 0%
New 10%
New 10%
New 10%
New 0%
New 20%


Also available in: PDF PNG
