Project

General

Profile

Gantt

Filters

Zoom in Zoom out « October | December »

months from Apply Clear

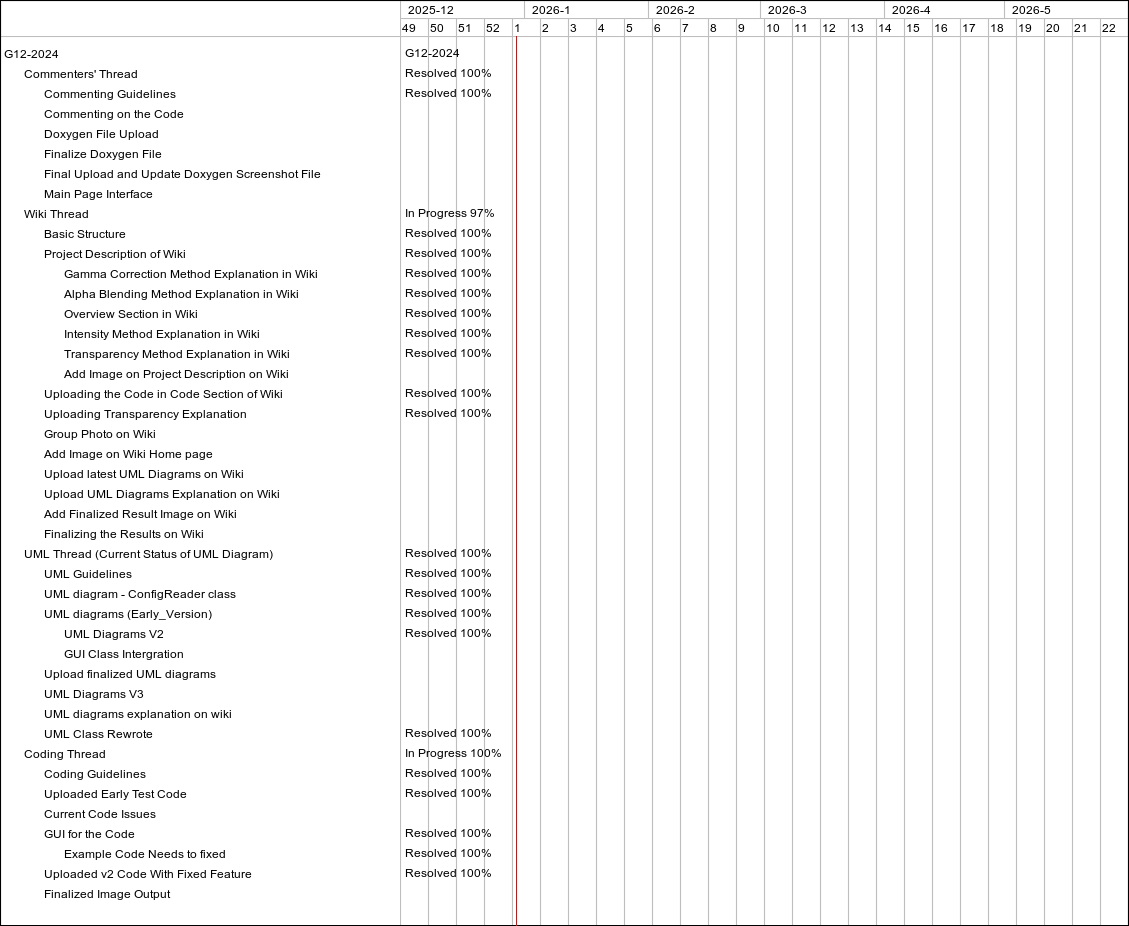

Support #1096: Commenters' Thread
Feature #1097: Commenting Guidelines
Feature #1134: Commenting on the Code
Feature #1136: Doxygen File Upload
Feature #1147: Finalize Doxygen File
Feature #1177: Final Upload and Update Doxygen Screenshot File
Bug #1180: Main Page Interface
Support #1091: Wiki Thread
Feature #1092: Basic Structure
Feature #1131: Project Description of Wiki
Feature #1133: Gamma Correction Method Explanation in Wiki
Feature #1138: Alpha Blending Method Explanation in Wiki
Feature #1139: Overview Section in Wiki
Feature #1144: Intensity Method Explanation in Wiki
Feature #1145: Transparency Method Explanation in Wiki
Support #1179: Add Image on Project Description on Wiki
Feature #1135: Uploading the Code in Code Section of Wiki
Support #1153: Uploading Transparency Explanation
Support #1168: Group Photo on Wiki
Support #1178: Add Image on Wiki Home page
Feature #1189: Upload latest UML Diagrams on Wiki
Feature #1190: Upload UML Diagrams Explanation on Wiki
Feature #1193: Add Finalized Result Image on Wiki
Support #1194: Finalizing the Results on Wiki
Support #1094: UML Thread (Current Status of UML Diagram)
Feature #1095: UML Guidelines
Support #1137: UML diagram - ConfigReader class
Feature #1105: UML diagrams (Early_Version)
Feature #1115: UML Diagrams V2
Support #1140: GUI Class Intergration
Feature #1149: Upload finalized UML diagrams
Feature #1166: UML Diagrams V3
Feature #1167: UML diagrams explanation on wiki
Support #1174: UML Class Rewrote
Support #1098: Coding Thread
Feature #1099: Coding Guidelines
Feature #1111: Uploaded Early Test Code
Feature #1113: Current Code Issues
Feature #1112: GUI for the Code
Feature #1123: Example Code Needs to fixed
Feature #1114: Uploaded v2 Code With Fixed Feature
Feature #1192: Finalized Image Output

Status

Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
In Progress
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
In Progress
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
In Progress
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved

Priority

High
Normal
Normal
Normal
High
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Low
Normal
Normal
Normal
Low
Normal
Normal
Normal
Normal
Urgent
Normal
Normal
High
High
Normal
High
High
Normal
Urgent
High
Normal
Normal
Normal
High
High
Normal
Normal

Updated

11/07/2024 01:59 PM
10/24/2024 03:45 PM
11/07/2024 01:47 PM
10/31/2024 01:13 PM
11/06/2024 04:01 PM
11/07/2024 01:45 PM
11/07/2024 02:04 PM
11/07/2024 02:02 PM
11/07/2024 01:45 PM
11/07/2024 02:00 PM
10/24/2024 03:36 PM
11/07/2024 01:43 PM
11/07/2024 01:51 PM
11/07/2024 01:43 PM
11/07/2024 01:44 PM
11/07/2024 02:00 PM
11/07/2024 01:51 PM
11/07/2024 01:45 PM
11/07/2024 01:46 PM
11/07/2024 01:46 PM
11/07/2024 01:54 PM
11/07/2024 01:55 PM
11/07/2024 01:59 PM
11/07/2024 02:02 PM
11/07/2024 01:56 PM
10/24/2024 03:46 PM
11/07/2024 01:46 PM
10/24/2024 03:45 PM
10/24/2024 03:34 PM
10/31/2024 01:43 PM
11/07/2024 01:56 PM
11/07/2024 01:48 PM
11/07/2024 10:44 AM
11/07/2024 01:48 PM
11/07/2024 02:06 PM
11/07/2024 01:47 PM
10/24/2024 03:21 PM
11/07/2024 02:06 PM
10/31/2024 03:40 PM
10/31/2024 03:42 PM
10/24/2024 03:40 PM
11/07/2024 01:55 PM


45
46
47
48
49
50
51
52
1
2
3
4
5
6
7
8
9
10
11
12
13
14
15
16
17
G12-2024
Resolved 100%
Resolved 100%
In Progress 97%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
In Progress 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%


Also available in: PDF PNG
