Project

General

Profile

Gantt

Filters

Zoom in Zoom out « February | April »

months from Apply Clear

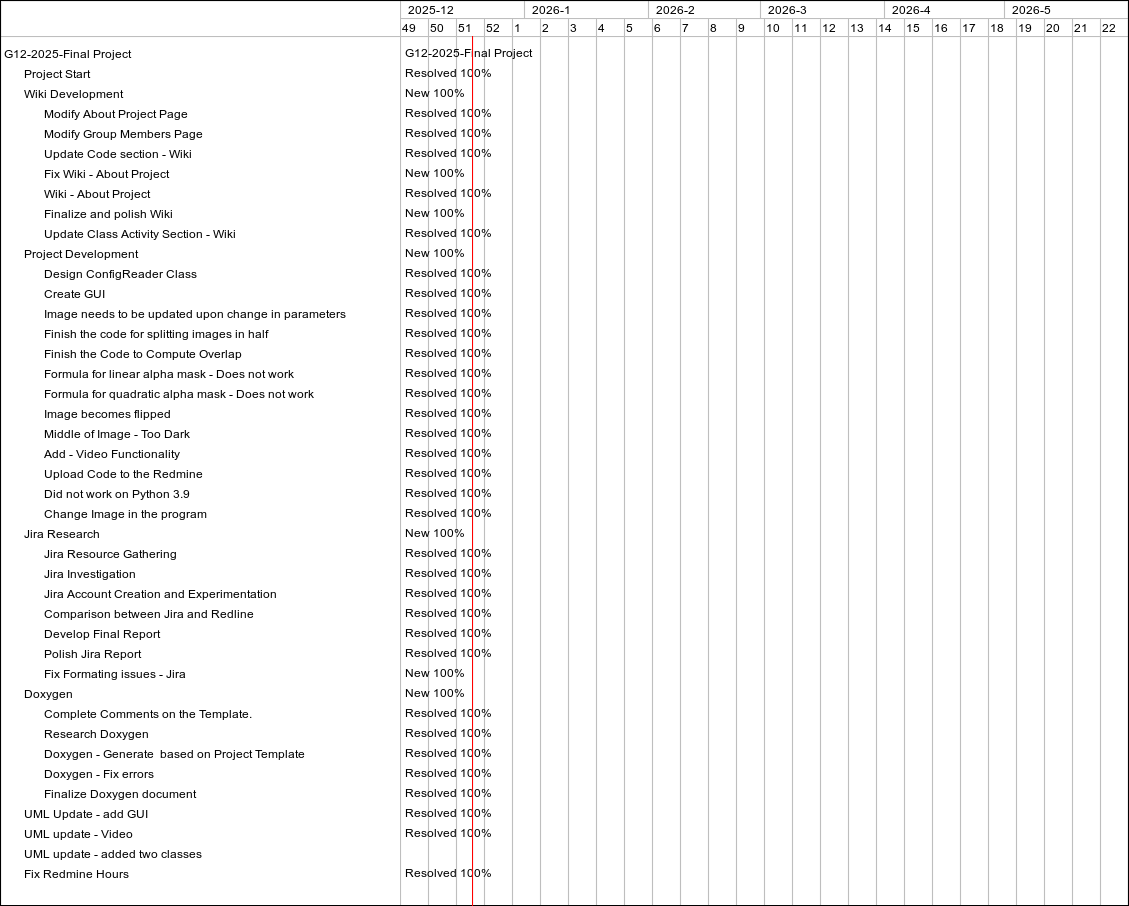

Feature #1392: Project Start
Feature #1393: Wiki Development
Feature #1413: Modify About Project Page
Feature #1414: Modify Group Members Page
Feature #1468: Update Code section - Wiki
Bug #1472: Fix Wiki - About Project
Feature #1473: Wiki - About Project
Feature #1465: Finalize and polish Wiki
Feature #1467: Update Class Activity Section - Wiki
Feature #1394: Project Development
Feature #1395: Design ConfigReader Class
Feature #1415: Create GUI
Feature #1416: Image needs to be updated upon change in parameters
Feature #1432: Finish the code for splitting images in half
Feature #1433: Finish the Code to Compute Overlap
Bug #1417: Formula for linear alpha mask - Does not work
Bug #1418: Formula for quadratic alpha mask - Does not work
Bug #1419: Image becomes flipped
Bug #1427: Middle of Image - Too Dark
Feature #1442: Add - Video Functionality
Feature #1466: Upload Code to the Redmine
Bug #1469: Did not work on Python 3.9
Feature #1470: Change Image in the program
Feature #1423: Jira Research
Feature #1424: Jira Resource Gathering
Feature #1425: Jira Investigation
Feature #1426: Jira Account Creation and Experimentation
Feature #1428: Comparison between Jira and Redline
Feature #1431: Develop Final Report
Feature #1452: Polish Jira Report
Feature #1471: Fix Formating issues - Jira
Feature #1434: Doxygen
Feature #1435: Complete Comments on the Template.
Feature #1436: Research Doxygen
Feature #1450: Doxygen - Generate based on Project Template
Bug #1451: Doxygen - Fix errors
Feature #1464: Finalize Doxygen document
Feature #1439: UML Update - add GUI
Feature #1440: UML update - Video
Feature #1447: UML update - added two classes
Bug #1474: Fix Redmine Hours

Status

Resolved
New
Resolved
Resolved
Resolved
New
Resolved
New
Resolved
New
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
New
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
New
New
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
New
Resolved

Priority

Normal
High
Normal
Normal
High
Normal
Normal
Normal
High
Urgent
Normal
High
High
High
High
High
High
High
High
High
Normal
Urgent
Urgent
High
Normal
Normal
Normal
Normal
Normal
Normal
High
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
High

Updated

11/13/2025 01:38 PM
11/13/2025 01:40 PM
11/13/2025 10:49 AM
11/13/2025 10:50 AM
11/13/2025 11:23 AM
11/13/2025 01:37 PM
11/13/2025 01:45 PM
11/13/2025 11:03 AM
11/13/2025 11:24 AM
11/13/2025 01:25 PM
11/13/2025 10:48 AM
11/13/2025 10:54 AM
11/13/2025 10:55 AM
11/13/2025 10:55 AM
11/13/2025 10:56 AM
11/13/2025 10:55 AM
11/13/2025 10:55 AM
11/13/2025 10:51 AM
11/13/2025 10:55 AM
11/13/2025 10:51 AM
11/13/2025 11:05 AM
11/13/2025 01:26 PM
11/13/2025 01:33 PM
11/13/2025 01:40 PM
11/13/2025 01:58 PM
11/13/2025 01:57 PM
11/13/2025 10:52 AM
11/13/2025 10:53 AM
11/13/2025 10:53 AM
11/13/2025 01:39 PM
11/13/2025 01:35 PM
11/13/2025 11:02 AM
11/13/2025 10:58 AM
11/13/2025 10:58 AM
11/13/2025 10:58 AM
11/06/2025 01:21 PM
11/13/2025 11:11 AM
11/13/2025 11:00 AM
11/13/2025 10:58 AM
11/04/2025 07:00 PM
11/13/2025 01:47 PM


10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
G12-2025-Final Project
Resolved 100%
New 100%
Resolved 100%
Resolved 100%
Resolved 100%
New 100%
Resolved 100%
New 100%
Resolved 100%
New 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
New 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
New 100%
New 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%


Also available in: PDF PNG
