Project

General

Profile

Gantt

Filters

Zoom in Zoom out « January | March »

months from Apply Clear

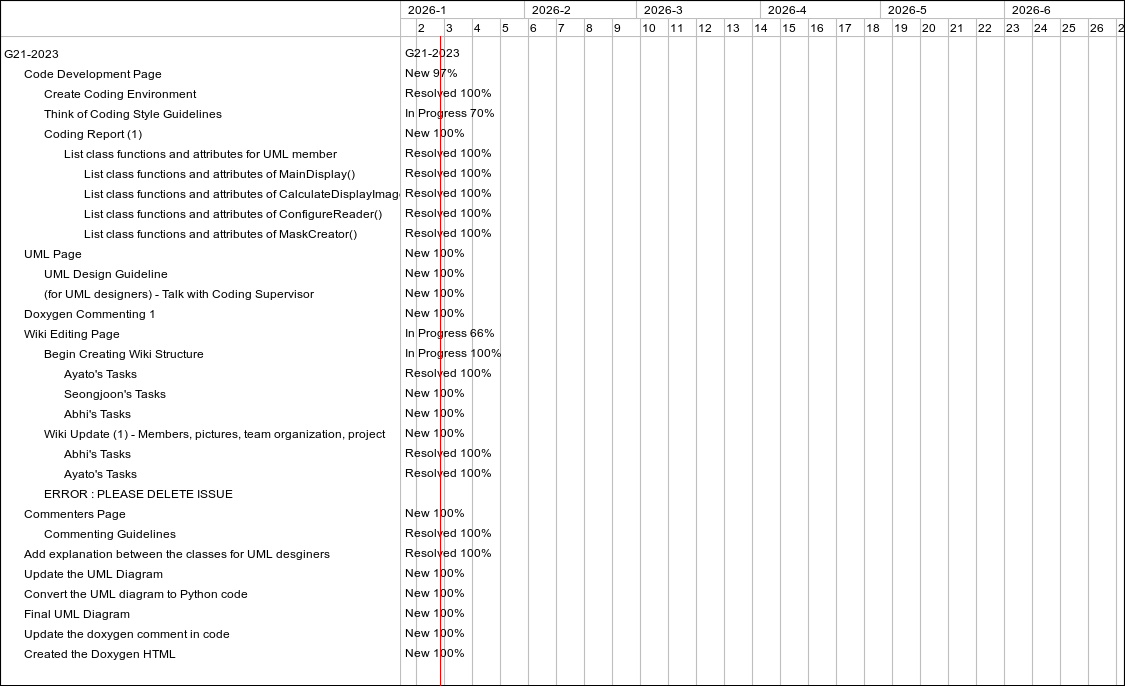

Feature #890: Code Development Page
Feature #894: Create Coding Environment
Feature #896: Think of Coding Style Guidelines
Feature #911: Coding Report (1)
Feature #916: List class functions and attributes for UML member
Feature #917: List class functions and attributes of MainDisplay()
Feature #918: List class functions and attributes of CalculateDisplayImage()
Feature #919: List class functions and attributes of ConfigureReader()
Feature #920: List class functions and attributes of MaskCreator()
Feature #892: UML Page
Feature #910: UML Design Guideline
Feature #909: (for UML designers) - Talk with Coding Supervisor
Feature #901: Doxygen Commenting 1
Feature #889: Wiki Editing Page
Feature #899: Begin Creating Wiki Structure
Feature #906: Ayato's Tasks
Feature #907: Seongjoon's Tasks
Feature #915: Abhi's Tasks
Feature #908: Wiki Update (1) - Members, pictures, team organization, project
Feature #912: Abhi's Tasks
Feature #913: Ayato's Tasks
Bug #914: ERROR : PLEASE DELETE ISSUE
Feature #891: Commenters Page
Feature #928: Commenting Guidelines
Feature #925: Add explanation between the classes for UML desginers
Feature #926: Update the UML Diagram
Feature #927: Convert the UML diagram to Python code
Feature #943: Final UML Diagram
Feature #944: Update the doxygen comment in code
Feature #945: Created the Doxygen HTML

Status

New
Resolved
In Progress
New
Resolved
Resolved
Resolved
Resolved
Resolved
New
New
New
New
In Progress
In Progress
Resolved
New
New
New
Resolved
Resolved
New
New
Resolved
Resolved
New
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Updated

01/10/2024 06:02 PM
12/21/2023 01:52 PM
12/21/2023 02:56 PM
01/10/2024 06:02 PM
01/10/2024 11:54 PM
01/11/2024 01:16 PM
01/11/2024 04:11 AM
01/09/2024 09:46 AM
01/11/2024 03:01 PM
12/21/2023 03:26 PM
12/21/2023 02:16 PM
12/21/2023 03:26 PM
01/11/2024 02:08 PM
01/11/2024 12:37 AM
12/27/2023 04:18 AM
01/18/2024 01:03 PM
12/27/2023 04:18 AM
12/21/2023 03:36 PM
01/11/2024 12:37 AM
01/11/2024 12:37 AM
01/18/2024 01:03 PM
12/21/2023 03:35 PM
01/11/2024 02:08 PM
01/11/2024 02:09 PM
01/11/2024 02:03 PM
01/11/2024 01:27 PM
01/11/2024 01:32 PM
01/18/2024 01:38 PM
01/18/2024 01:39 PM
01/18/2024 02:02 PM


6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
G21-2023
New 97%
Resolved 100%
In Progress 70%
New 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
New 100%
New 100%
New 100%
New 100%
In Progress 66%
In Progress 100%
Resolved 100%
New 100%
New 100%
New 100%
Resolved 100%
Resolved 100%
New 100%
Resolved 100%
Resolved 100%
New 100%
New 100%
New 100%
New 100%
New 100%


Also available in: PDF PNG
