Project

General

Profile

Gantt

Filters

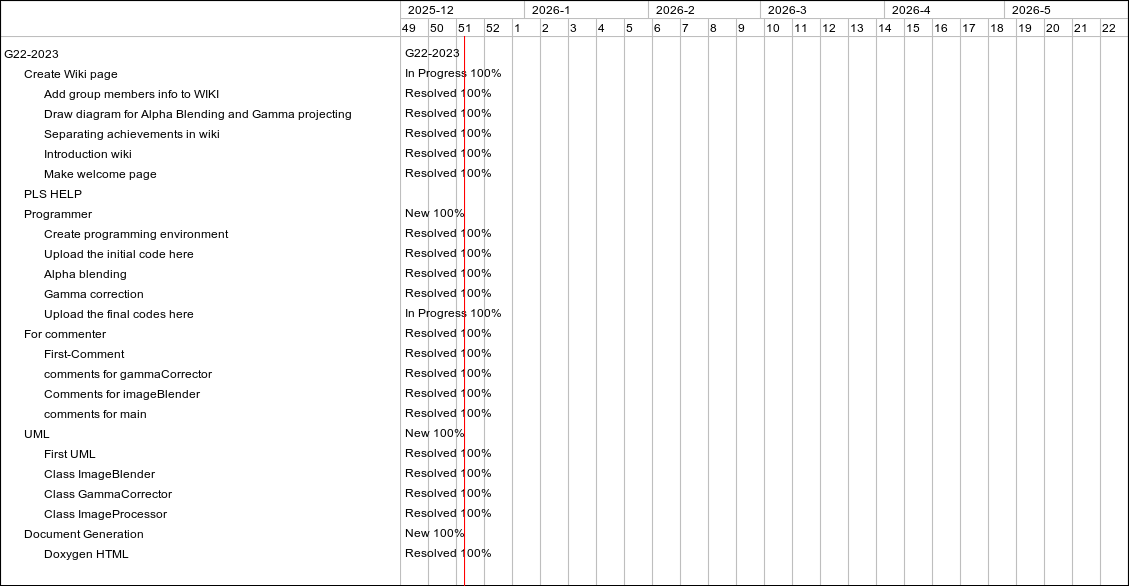

Zoom in Zoom out « December 2025 | February »

months from Apply Clear

Feature #893: Create Wiki page
Feature #903: Add group members info to WIKI
Feature #932: Draw diagram for Alpha Blending and Gamma projecting
Feature #933: Separating achievements in wiki
Feature #941: Introduction wiki
Feature #942: Make welcome page
Support #898: PLS HELP
Feature #900: Programmer
Feature #902: Create programming environment
Feature #904: Upload the initial code here
Feature #923: Alpha blending
Feature #924: Gamma correction
Feature #922: Upload the final codes here
Feature #934: For commenter
Feature #897: First-Comment
Feature #929: comments for gammaCorrector
Feature #930: Comments for imageBlender
Feature #931: comments for main
Feature #895: First UML
Feature #936: Class ImageBlender
Feature #937: Class GammaCorrector
Feature #938: Class ImageProcessor
Feature #921: Document Generation
Feature #940: Doxygen HTML

Status

In Progress
Resolved
Resolved
Resolved
Resolved
Resolved
New
New
Resolved
Resolved
Resolved
Resolved
In Progress
Resolved
Resolved
Resolved
Resolved
Resolved
New
Resolved
Resolved
Resolved
Resolved
New
Resolved

Priority

High
Normal
High
Normal
Normal
Normal
Urgent
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Updated

01/18/2024 01:42 PM
01/18/2024 01:42 PM
01/18/2024 01:36 PM
01/18/2024 01:36 PM
01/18/2024 01:34 PM
01/18/2024 01:34 PM
12/14/2023 04:09 PM
01/18/2024 01:42 PM
01/11/2024 03:44 PM
01/11/2024 03:49 PM
01/11/2024 03:47 PM
01/11/2024 03:46 PM
01/18/2024 01:42 PM
01/18/2024 01:32 PM
01/18/2024 01:32 PM
01/18/2024 01:33 PM
01/18/2024 01:32 PM
01/18/2024 01:32 PM
01/17/2024 09:20 AM
01/11/2024 03:56 PM
01/18/2024 01:32 PM
01/18/2024 01:32 PM
01/18/2024 01:31 PM
01/18/2024 01:36 PM
01/18/2024 01:36 PM


2
3
4
5
6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
G22-2023
In Progress 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
New 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
In Progress 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
New 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
New 100%
Resolved 100%


Also available in: PDF PNG
