Project

General

Profile

Gantt

Filters

Zoom in Zoom out « October | December »

months from Apply Clear

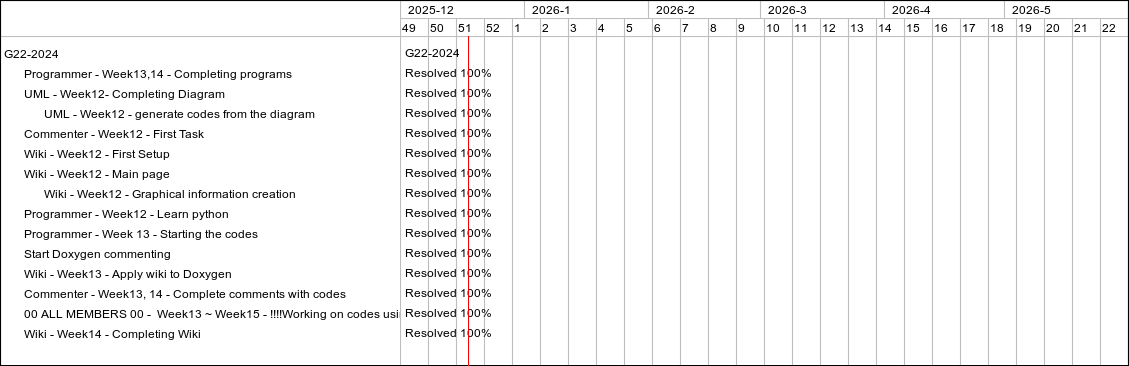

Feature #1267: Programmer - Week13,14 - Completing programs
Feature #1268: UML - Week12- Completing Diagram
Feature #1282: UML - Week12 - generate codes from the diagram
Feature #1269: Commenter - Week12 - First Task
Feature #1270: Wiki - Week12 - First Setup
Feature #1279: Wiki - Week12 - Main page
Feature #1281: Wiki - Week12 - Graphical information creation
Support #1285: Programmer - Week12 - Learn python
Support #1314: Programmer - Week 13 - Starting the codes
Feature #1315: Start Doxygen commenting
Feature #1280: Wiki - Week13 - Apply wiki to Doxygen
Feature #1283: Commenter - Week13, 14 - Complete comments with codes
Support #1324: 00 ALL MEMBERS 00 - Week13 ~ Week15 - !!!!Working on codes using GitHub!!!!
Feature #1284: Wiki - Week14 - Completing Wiki

Status

Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved

Priority

High
Normal
Normal
High
High
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Urgent
Normal

Updated

01/16/2025 01:59 PM
01/16/2025 01:58 PM
12/22/2024 01:55 PM
12/20/2024 03:53 PM
12/12/2024 11:46 PM
12/22/2024 01:56 PM
12/19/2024 02:47 PM
12/19/2024 02:12 PM
01/16/2025 01:56 PM
01/08/2025 12:14 AM
01/16/2025 01:57 PM
01/16/2025 01:57 PM
01/16/2025 01:56 PM
01/16/2025 01:57 PM


45
46
47
48
49
50
51
52
1
2
3
4
5
6
7
8
9
10
11
12
13
14
15
16
17
G22-2024
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%


Also available in: PDF PNG
