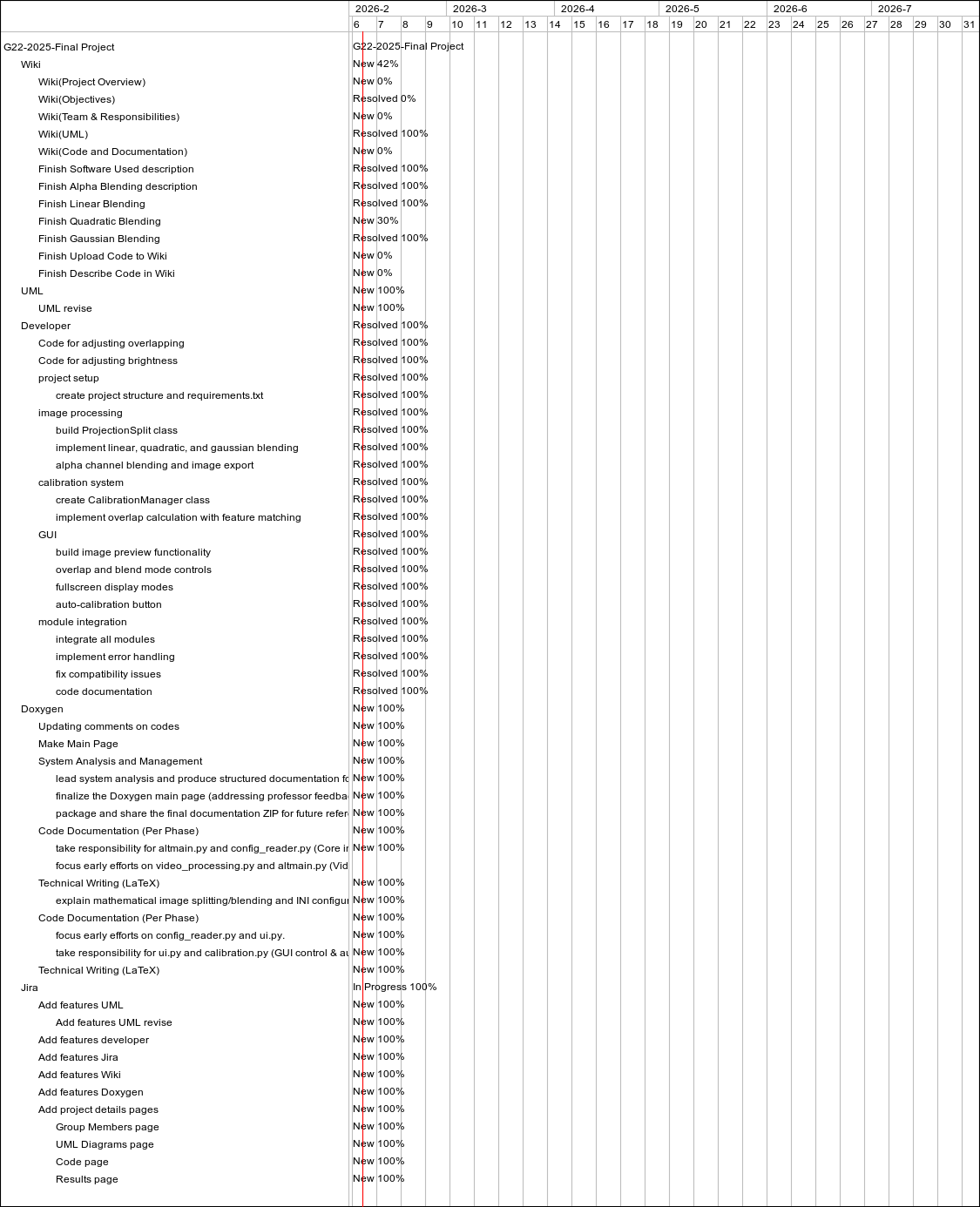

Project

General

Profile

Gantt

Filters

Zoom in Zoom out « February | April »

months from Apply Clear

Feature #1497: Wiki(Project Overview)
Feature #1498: Wiki(Objectives)
Feature #1499: Wiki(Team & Responsibilities)
Feature #1500: Wiki(UML)
Feature #1501: Wiki(Code and Documentation)
Feature #1491: Developer
Feature #1553: project setup
Feature #1555: image processing
Feature #1556: build ProjectionSplit class
Feature #1557: implement linear, quadratic, and gaussian blending
Feature #1558: alpha channel blending and image export
Feature #1559: calibration system
Feature #1560: create CalibrationManager class
Feature #1561: implement overlap calculation with feature matching
Feature #1563: build image preview functionality
Feature #1564: overlap and blend mode controls
Feature #1565: fullscreen display modes
Feature #1566: auto-calibration button
Feature #1567: module integration
Feature #1568: integrate all modules
Feature #1569: implement error handling
Feature #1570: fix compatibility issues
Feature #1571: code documentation
Feature #1495: Doxygen
Feature #1541: Make Main Page
Feature #1578: take responsibility for altmain.py and config_reader.py (Core image algorithms & configuration logic).
Feature #1579: Technical Writing (LaTeX)
Feature #1580: explain mathematical image splitting/blending and INI configuration management
Feature #1581: Code Documentation (Per Phase)
Feature #1582: focus early efforts on config_reader.py and ui.py.
Feature #1583: take responsibility for ui.py and calibration.py (GUI control & automatic alignment)
Feature #1584: Technical Writing (LaTeX)
Feature #1542: Add features UML
Feature #1547: Add features UML revise
Feature #1543: Add features developer
Feature #1544: Add features Jira
Feature #1545: Add features Wiki
Feature #1546: Add features Doxygen
Feature #1548: Add project details pages
Feature #1549: Group Members page
Feature #1550: UML Diagrams page
Feature #1551: Code page
Feature #1552: Results page

Status

New
New
Resolved
New
Resolved
New
New
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
New
New
New
New
New
New
New
New
New
In Progress
New
New
New
New
New
New
New
New
New
New
New

Priority

High
Normal
Normal
Normal
Normal
Normal
High
Urgent
High
High
Low
High
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Urgent
High
Normal
Urgent
High
High
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
High
Normal
Normal
Normal
Normal
Normal
Normal
High
High
High
Normal
Normal

Updated

01/08/2026 01:35 PM
12/11/2025 03:41 PM
01/08/2026 02:40 PM
12/11/2025 03:50 PM
12/18/2025 02:09 PM
12/11/2025 03:47 PM
12/25/2025 03:35 PM
01/10/2026 09:32 PM
01/10/2026 09:16 PM
01/10/2026 09:17 PM
01/10/2026 09:17 PM
01/10/2026 09:16 PM
01/10/2026 09:13 PM
01/10/2026 09:17 PM
01/10/2026 09:17 PM
01/10/2026 09:16 PM
01/10/2026 09:21 PM
01/10/2026 09:17 PM
01/10/2026 09:20 PM
01/10/2026 09:21 PM
01/10/2026 09:16 PM
01/10/2026 09:17 PM
01/10/2026 09:16 PM
01/10/2026 09:16 PM
01/10/2026 09:12 PM
01/10/2026 09:17 PM
01/08/2026 02:29 PM
01/04/2026 09:44 PM
01/08/2026 02:29 PM
01/08/2026 02:29 PM
01/08/2026 02:29 PM
01/08/2026 02:29 PM
01/08/2026 02:29 PM
01/08/2026 02:29 PM
01/08/2026 02:28 PM
01/08/2026 02:14 PM
01/08/2026 12:49 PM
01/08/2026 12:49 PM
01/08/2026 12:51 PM
01/08/2026 12:51 PM
01/08/2026 12:50 PM
01/08/2026 12:50 PM
01/07/2026 12:01 AM
01/07/2026 12:00 AM
01/07/2026 12:01 AM
01/07/2026 12:00 AM
01/06/2026 11:59 PM


10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
G22-2025-Final Project
New 42%
New 0%
Resolved 0%
New 0%
Resolved 100%
New 0%
New 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
In Progress 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%


Also available in: PDF PNG
