Project

General

Profile

Gantt

Filters

Zoom in Zoom out « January | March »

months from Apply Clear

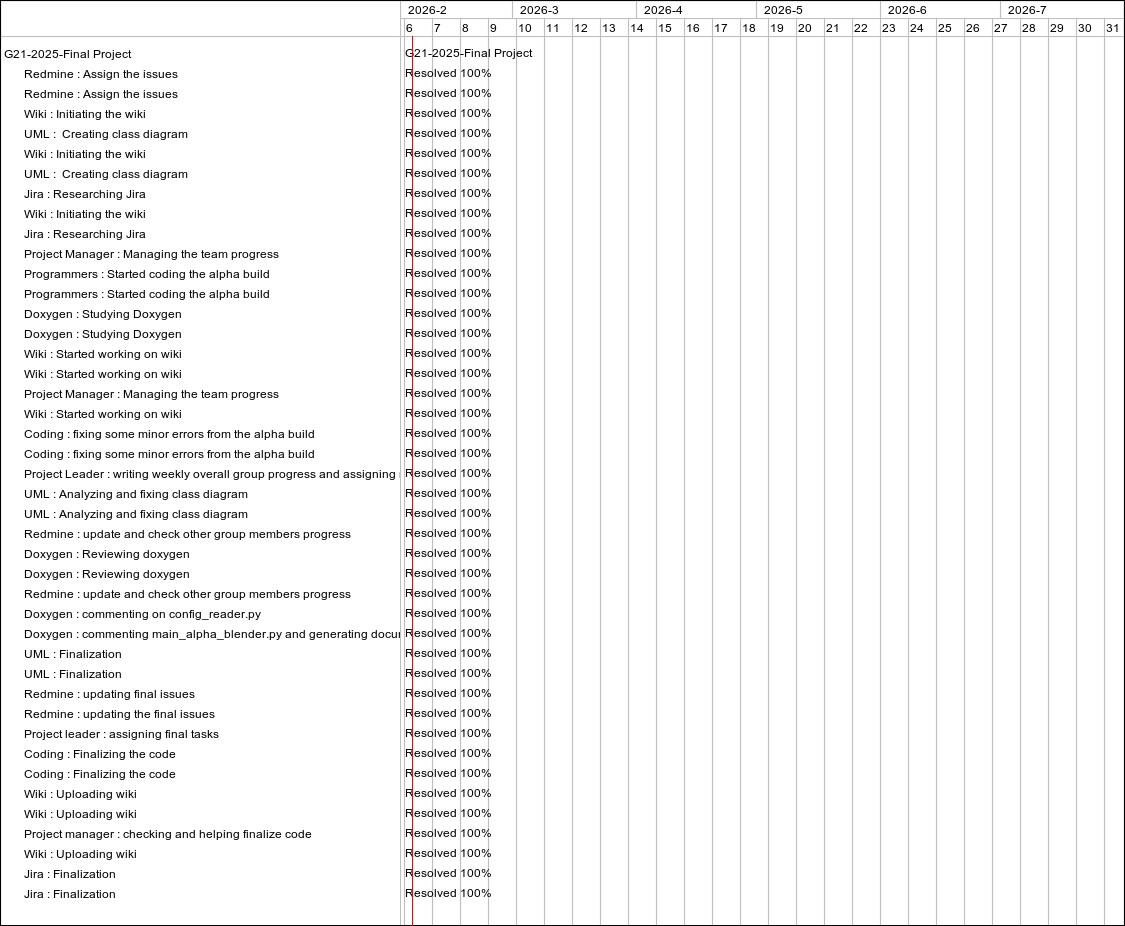

Feature #1478: Redmine : Assign the issues
Feature #1479: Redmine : Assign the issues
Feature #1480: Wiki : Initiating the wiki
Feature #1481: UML : Creating class diagram
Feature #1482: Wiki : Initiating the wiki
Feature #1483: UML : Creating class diagram
Feature #1484: Jira : Researching Jira
Feature #1485: Wiki : Initiating the wiki
Feature #1486: Jira : Researching Jira
Feature #1490: Project Manager : Managing the team progress
Feature #1492: Programmers : Started coding the alpha build
Feature #1493: Programmers : Started coding the alpha build
Feature #1487: Doxygen : Studying Doxygen
Feature #1488: Doxygen : Studying Doxygen
Feature #1502: Wiki : Started working on wiki
Feature #1503: Wiki : Started working on wiki
Feature #1504: Project Manager : Managing the team progress
Feature #1505: Wiki : Started working on wiki
Feature #1506: Coding : fixing some minor errors from the alpha build
Feature #1507: Coding : fixing some minor errors from the alpha build
Feature #1508: Project Leader : writing weekly overall group progress and assigning new tasks
Feature #1509: UML : Analyzing and fixing class diagram
Feature #1510: UML : Analyzing and fixing class diagram
Feature #1512: Redmine : update and check other group members progress
Feature #1513: Doxygen : Reviewing doxygen
Feature #1514: Doxygen : Reviewing doxygen
Feature #1511: Redmine : update and check other group members progress
Feature #1518: Doxygen : commenting on config_reader.py
Feature #1519: Doxygen : commenting main_alpha_blender.py and generating documention
Feature #1520: UML : Finalization
Feature #1521: UML : Finalization
Feature #1522: Redmine : updating final issues
Feature #1523: Redmine : updating the final issues
Feature #1524: Project leader : assigning final tasks
Feature #1525: Coding : Finalizing the code
Feature #1526: Coding : Finalizing the code
Feature #1528: Wiki : Uploading wiki
Feature #1529: Wiki : Uploading wiki
Feature #1530: Project manager : checking and helping finalize code
Feature #1531: Wiki : Uploading wiki
Feature #1532: Jira : Finalization
Feature #1533: Jira : Finalization

Status

Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved
Resolved

Priority

Urgent
Urgent
Normal
Normal
Normal
Normal
Low
Normal
Low
Low
Urgent
Urgent
Normal
Normal
Normal
Normal
Normal
Normal
Urgent
Normal
Urgent
Normal
Normal
Urgent
Normal
Normal
Urgent
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Updated

12/25/2025 02:34 PM
12/25/2025 02:34 PM
12/25/2025 02:48 PM
12/25/2025 02:49 PM
12/25/2025 02:48 PM
12/25/2025 02:49 PM
12/25/2025 02:54 PM
12/25/2025 02:48 PM
12/25/2025 02:56 PM
12/25/2025 02:53 PM
12/25/2025 03:12 PM
12/25/2025 03:12 PM
12/25/2025 02:51 PM
12/25/2025 02:51 PM
12/25/2025 03:11 PM
12/25/2025 03:12 PM
12/25/2025 02:53 PM
12/25/2025 03:13 PM
12/25/2025 03:11 PM
12/25/2025 03:11 PM
12/25/2025 03:12 PM
12/25/2025 03:13 PM
12/25/2025 03:13 PM
12/25/2025 03:13 PM
12/25/2025 03:14 PM
12/25/2025 03:14 PM
12/25/2025 03:15 PM
01/08/2026 01:09 PM
01/08/2026 01:10 PM
01/08/2026 01:11 PM
01/08/2026 01:14 PM
01/08/2026 03:10 PM
01/08/2026 03:11 PM
01/08/2026 03:10 PM
01/08/2026 01:06 PM
01/08/2026 01:06 PM
01/08/2026 03:09 PM
01/08/2026 01:06 PM
01/08/2026 03:11 PM
01/08/2026 03:12 PM
01/08/2026 03:08 PM
01/08/2026 03:07 PM


6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
G21-2025-Final Project
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%
Resolved 100%


Also available in: PDF PNG
